Footpath Renewal Program
| What we're doing: | Council is dedicated to the ongoing maintenance and improvement of local infrastructure through its structured renewal programs.. |
|---|---|
| How much is it going to cost: | $927,000 |
| Timeframe: | 2026/27 |
| Background: | Directly impacted residents will receive advance notification regarding the commencement date. Unless otherwise advised, typical construction hours will occur between the hours of 7:00am and 5:00pm, Monday to Saturday. During the course of these works, vehicle access to properties may be temporarily restricted, particularly where works are being undertaken across affected driveways. Council’s contractor will implement reasonable measures to minimise inconvenience wherever possible. Council respectfully requests that any privately planted vegetation encroaching upon the footpath area be pruned prior to the commencement of works. Should vegetation be found to obstruct the footpath or impede the footpath renewal, Council reserves the right to prune or remove such vegetation at its discretion. During construction of the footpath works, please adhere to any traffic control signage and detours that may be in place and plan alternate routes to avoid delay in reaching your destination. Council endeavours to complete the Footpath Renewal Program within the indicated year, however the program can be subject to change due to unforeseen circumstances. If this occurs the affected segment will be scheduled in a future works program. |
Financial Year 2026/27
| Road | Location |
|---|---|
| Balhannah Road | 11m east Mount Barker Rd to Church St |
| Church Street | 12 Church St to Balhannah Rd |
| Church Street | Victoria St to 12 Church St |
| Exhibition Road | Hampden Rd to Alexandrina Rd |
| Hutchinson Street | Dunn St to opposite Pridmore Tce |
| Pine Avenue | 24m south Mount Barker Rd to Auricht Rd |
| Pine Avenue | 41m south Mount Barker Rd to Auricht Rd |
| Mann Street | Hack St to Adelaide Rd |
| Victoria Road | Wunderley Dr to Wellington Rd |
| Mount Barker Road | 1A Mount Barker Rd to Auricht Rd |
| Linear Trail | Library Carpark to Adelaide Rd Intersection |

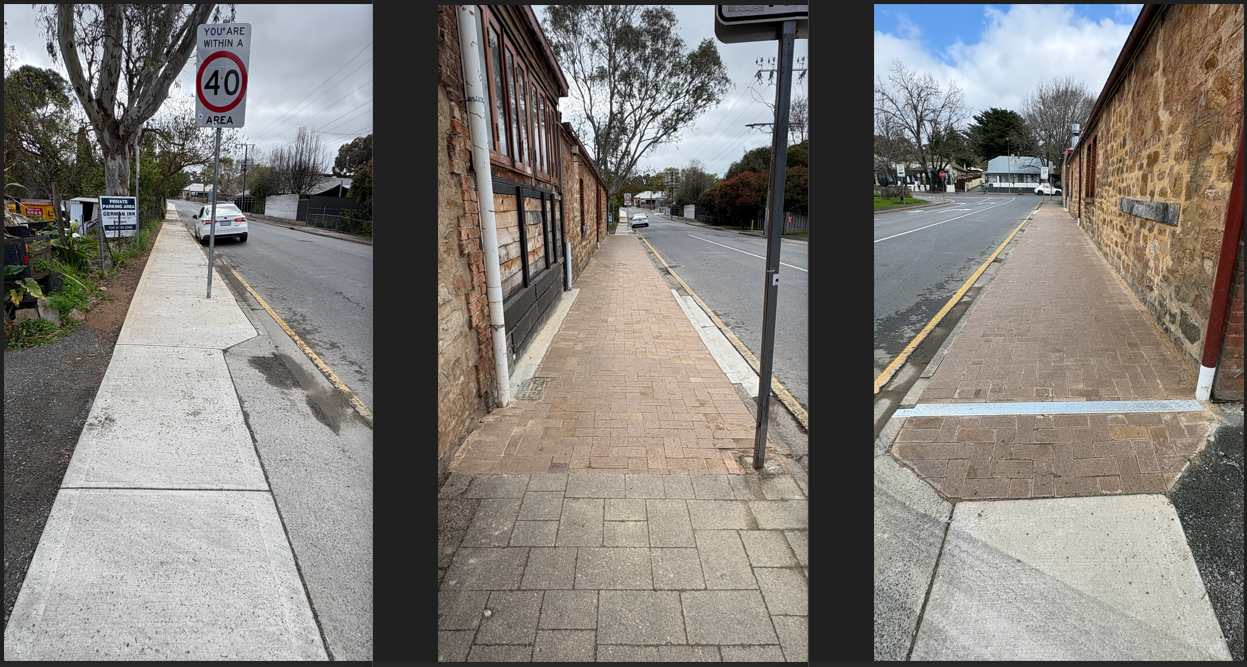

Pine Avenue, Church Street and Balhannah Road
September 2026
Renewal of the footpaths along these sections of roads included in the 2026/27 footpath renewal program are now complete.

Footpath | Segment | Financial Year | Status | Project Details |
|---|---|---|---|---|
Smeaton Crescent, Littlehampton | Cowan Avenue to Gumtree Drive | 2025/26 | Complete | Replace existing footpath with a new grey concrete footpath including new pram ramps and retaining wall works as required. |
Gumtree Drive, Littlehampton | Reserve to Smeaton Crescent | 2025/26 | Complete | Replace existing footpath with a new grey concrete footpath |
Benjamin Grey Drive, Littlehampton | Miels Avenue to Gum Tree Drive | 2025/26 | Construction planned to commence April 2026 | Replace existing footpath with a new grey concrete footpath |
West Terrace, Littlehampton | North Tce to Baker St | 2025/26 | Construction planned for Apr-Jun 2026 | Replace existing asphalt footpath with a new grey 1.8m wide concrete footpath |
Gallasch Drive, Mount Barker | Full Length | 2025/26 | Complete | Replace existing paved footpath with a new grey concrete footpath |
Majestic Drive, Mount Barker | Greenfield St to Lawson St | 2025/26 | Commenced, works to be complete by end of June 2026 | Lift and relay several patches of paving due to tree root impact. This may result in slight realignment of the footpath and or elevation of the footpath if required. |
Pollard Street, Mount Barker | Greenfield St to Lawson St | 2025/26 | Commenced, works to be complete by end of June 2026 | Lift and relay several patches of paving due to tree root impact. This may result in slight realignment of the footpath and or elevation of the footpath if required. |
Hurling Drive, Mount Barker | Laver St to East Parkway | 2025/26 | Complete | Lift and relay several patches of paving due to tree root impact. This may result in slight realignment of the footpath and or elevation of the footpath if required. |
Greenfield Street, Mount Barker | Laver St to Pollard St | 2025/26 | In progress | Lift and relay several patches of paving due to tree root impact. This may result in slight realignment of the footpath and or elevation of the footpath if required. |
Trapper Court, Mount Barker | Hurling Drive to 16 Trapper Court | 2025/26 | Complete | Lift and relay several patches of paving due to tree root impact. This may result in slight realignment of the footpath and or elevation of the footpath if required. |
Tilly Road, Mount Barker | Biar St to West Parkway | 2025/26 | Construction planned for May-Jun 2026 | Lift and relay several patches of paving due to tree root impact. This may result in slight realignment of the footpath and or elevation of the footpath if required. |
Saint James Drive, Littlehampton | In front of #7 and #9 Saint James Drive | 2025/26 | Construction planned for Apr-Jun 2026 | Replace section of concrete footpath with a new grey concrete footpath |
| Footpath | Segment | Financial Year | Status | Project Details |
|---|---|---|---|---|
Kia Ora Street (left), Mount Barker | Kia Ora Street | 2024/25 | Complete | Asphalt footpath approximately 1.8m wide to be installed on the Northern side of Kia Ora street with connectivity down to the bridge. |
Linear Trail | Alexandrina Road to the Railway bridge | 2024/25 | Complete | Renew the Bitumate surface with an asphalt surface |
Laratinga Wetlands Unsealed Paths | Laratinga Wetlands | 2024/25 | Complete | Renew unsealed gravel paths |
| Footpath | Segment | Financial Year | Status | Project Details |
|---|---|---|---|---|
| Matthew Smilie Drive Reserve, Nairne | Jeffrey Street to Britannia Road | 2023/24 | Complete | Renewal of asphalt footpath through the reserve with improved connectivity to the courts |
| Old Princes Highway, Nairne | Chestnut Drive to Woodside Rod | 2023/24 | Complete | |
| Luck Street, Macclesfield | Vernon Street to Devereux Street | 2023/24 | Complete | |
| Bartley Street Nairne (Stage 1) | Matthew Smillie Dive to Edinborough Street | 2023/24 | Complete | |
| South Terrace, Nairne | Market Place to 22 Princes Highway | 2023/24 | Complete | |
| Kia Ora Street (left), Mount Barker | Kia Ora Street | 2023/24 | Deferred due to SA Water Main | Asphalt footpath approximately 1.8m wide to be installed on the Northern side of Kia Ora street with connectivity down to the bridge. |
| Andrewville Terrace, Littlehampton | Benjamin Gray Drive to Spring Park Drive | 2023/24 | Complete | 1.5 m wide concrete footpath to replace existing gravel path. |
| Benjamin Gray Drive, Littlehampton | Junction Road to Gamlin Court | 2023/24 | Complete | 1.5 m wide concrete footpath to replace existing gravel path. |
| Benjamin Gray Drive, Littlehampton | Gamlin Court Pedestrian Bridge to Reddy Close | 2023/24 | Complete | 1.5 m wide concrete footpath to replace existing gravel path. |
| Benjamin Gray Drive, Littlehampton | Reddy Close to Miels Avenue | 2023/24 | Complete | 1.5 m wide concrete footpath to replace existing gravel path. |
| Saleyard Road, Nairne | School entrance to Walker Court | 2023/24 | Complete | Concrete footpath approximately 1.8m wide |
| Victoria Road Walkway, Mount Barker | Victoria road to Alberg Avenue | 2023/24 | Complete | Concrete footpath to replace existing asphalt path with improved connectivity to Separation Avenue. |
| Separation Avenue, Mount Barker | Victoria Road Walkway to #18 Separation Avenue | 2023/24 | Complete | Concrete footpath approximately 1.5-1.8m wide |
| Mann Street, Mount Barker | Kia Ora Street to Gawler Street | 2023/24 | to be completed with Kia Ora Street | Construction of Asphalt footpath to connect the new footpath on Kia Ora street with Gawler street roundabout. Includes pedestrian crossing point on Mann Street. |
| Wellington Road, Mount Barker | Railway Terrace to Victoria Road | 2023/24 | Complete | |
| 2022/23 | ||||
| Wellington Rd, Mount Barker | Victoria Rd to Cedar Ave | 2022/23 | Complete | Concrete Footpath on Southern side from Victoria Road Roundabout through to pedestrian crossing adjacent to the Mount Barker Hospital |
| Murray St, Callington | Montefiore to Erskine Bridge | 2022/23 | Deferred | |
| Main St, Echunga | Eastern side, No 15-21 | 2022/23 | Deferred | To be constructed with future Main Street Upgrade |
| Pyrities Rd, Brukunga | Watts Rd to Shephard Rd | 2022/23 | Complete | Concrete Footpath including an improved crossing point at Shephard road intersection |
| Separation Ave, Mt Barker | Separation Ave to Whittaker Tce | 2022/23 | Complete | Concrete footpath through reserve |
| Springs Rd, Mt Barker | Karkoo Ct to Daddow Rd | 2022/23 | Complete | Concrete footpath, including a sealed carpark bay and a new bus stop pad |
| Smeaton Crs Walkway, Littlehampton | Smeaton Cr to Monks Ave | 2022/23 | Complete | Concrete footpath to replace existing rubble path |
| Legg Crt Walkway, Littlehampton | Legg Ct to Princes Hwy | 2022/23 | Complete | Concrete footpath to replace existing rubble path |
| 2021/22 | ||||
| North Terrace, Littlehampton | Coppins Road to Junction Road | 2021/22 | Complete | Included in Littlehampton Greening Project |
| Albert Place, Mount Barker | opposite 1 Albert Place to existing Newland Street footpath | 2021/22 | Complete | |
| Stephen Street, Mount Barker | Mann Street to Linear Trail | 2021/22 | Complete | |
| Wellington Road, Mount Barker | Flaxley Road to High School entry | 2021/22 | Complete | |
| Springs Road, Mount Barker | Karkoo Ct to end of gravel | 2021/22 | Complete | |
| Hutchinson Street, Mount Barker | Knott Street to Hampden Road | 2021/22 | Complete | |
| Exhibition Road, Mount Barker | Hampden Road to Fletcher Road | 2021/22 | Complete | |
| Bridge Street, Nairne | Main Road to Pedestrian Bridge | 2021/22 | Complete | |
| Main Road, Nairne | 122 to 132 Main Road | 2021/22 | Complete | |
| Pyrites Road, Brukunga | Shephard Road to 31 Pyrites Road | 2021/22 | Complete | |
| Woodside Road, Nairne | Stockham Street to Matthew Road | 2021/22 | Complete | |
| Laratinga Trail | Beginning of the wetlands to Bald Hills Road | 2021/22 | Complete |
